Construction Updates

Construction Updates for John Muir

January 2024 Updates from SDAT

At the January 2024 PTA meeting, Seattle Public Schools’ School Design Advisory Team (SDAT) provided the following updates:

  • Construction estimates for this project are over our $9.65 million budget.
  • ­been working to reduce cost while maintaining quality and supporting teaching and learning
  • ­scope that does not align with identified levy commitments has been removed from the project
  • We’re on schedule.

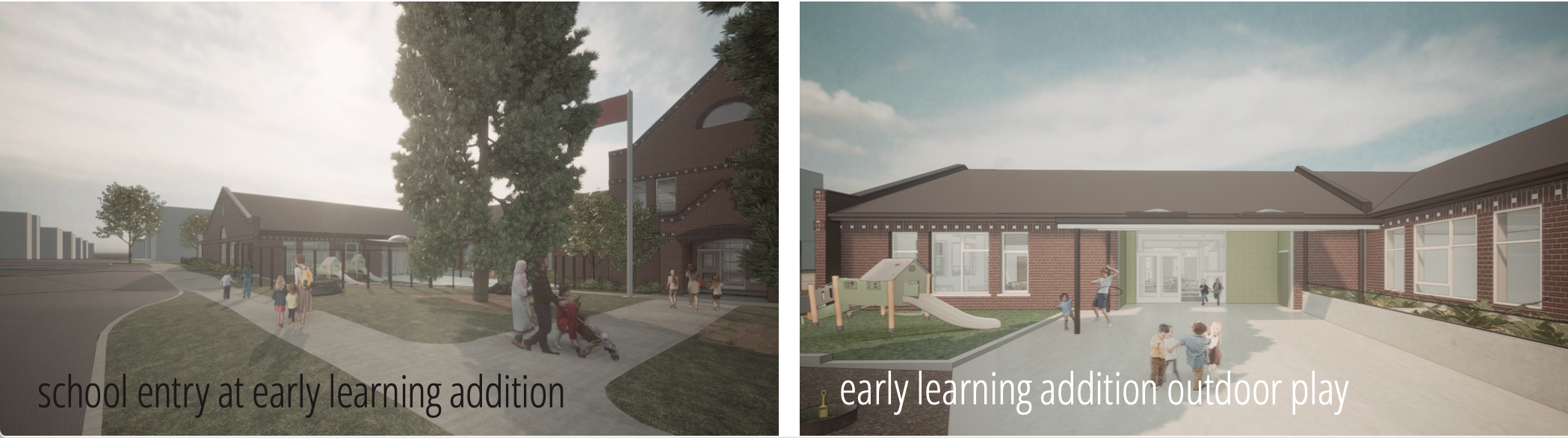

renderings of the Muir building. school entry at early learning addition
early learning addition outdoor play

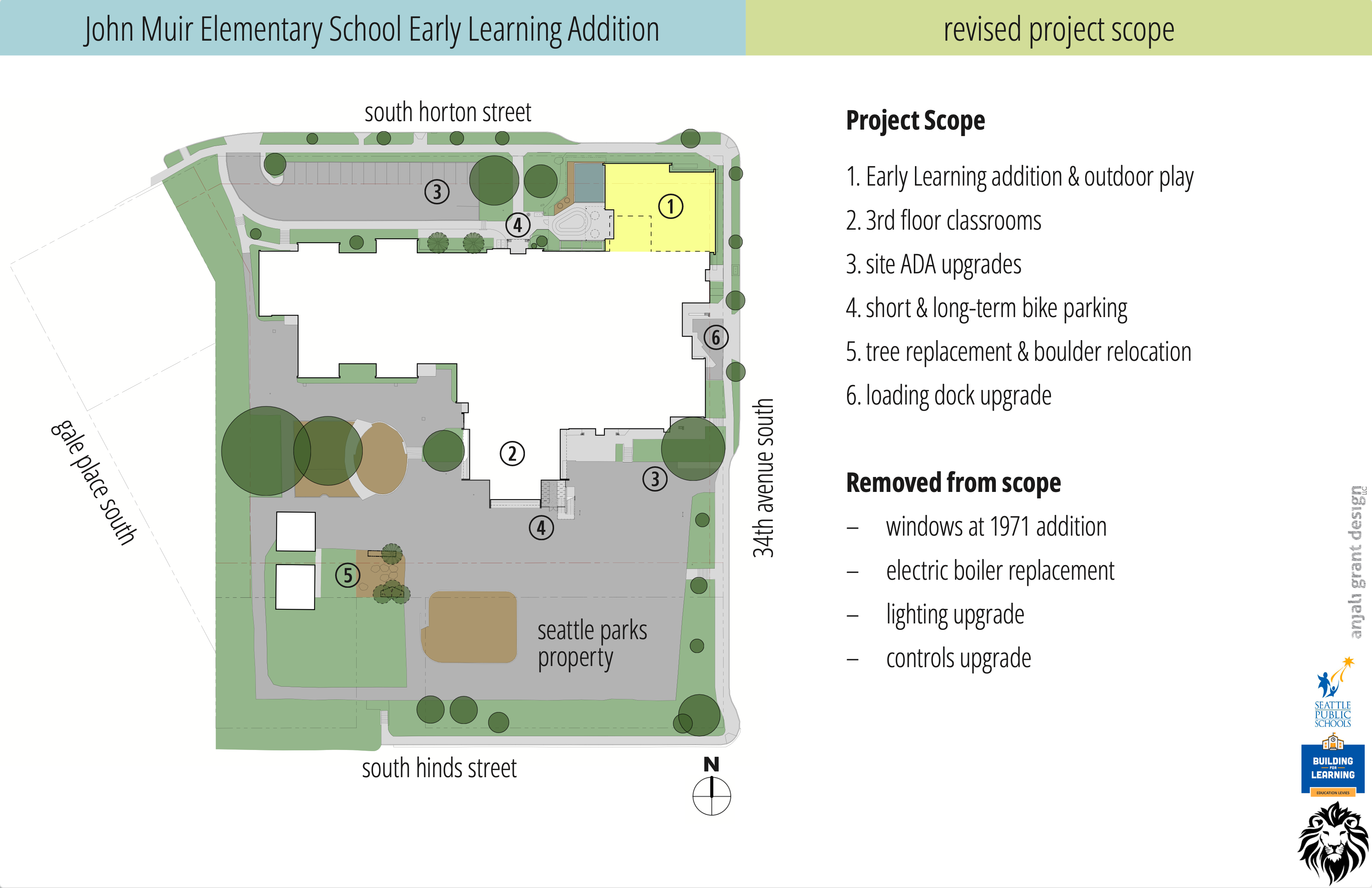

John Muir Elementary School Early Learning Addition map.

revised project scop
1. Early Learning addition & outdoor play
2. 3rd floor classrooms
3. site ADA upgrades
4. short & long-term bike parking
5. tree replacement & boulder relocation
6. loading dock upgrade

Removed from scope
- windows at 1971 addition
- electric boiler replacement
- lighting upgrade
- controls upgrade

Major Activity Completed This Period: December 2023

  • Completed User group meetings with Early Learning faculty and staff.
  • Completed Departures Advisory Committee meeting; verbally approved.
  • Continued construction document efforts and preparation of permit submittal and 65% CD set.

Major Activity Planned for Next Period: January 2024

  • Communicate scope reductions to school community.
  • Continue construction document efforts, preparation of permit submittal and 90% CD set.
  • Obtain Departures approval recommendation report from Department of Neighborhoods.
  • Host SEPA Hearing, which is scheduled for January 19, 2024, 10 – 4 pm.

Overview

In April of 2023, John Muir Elementary hosted a meeting to share more about upcoming construction and building improvements to share progress and solicit feedback from the community. The slides from the presentation give significant detail and context for SPS’ strategic plan, focus on equitable access and building welcoming schools, safety and maintenance processes, as well as more information about the district’s commitment to sustainability and climate. You can learn more about the planned changes below. Please note that the information below is subject to change as part of the design process.

  • Four classrooms and outdoor play area
  • Support spaces
  • Head start preschool and after-school program
  • Separate into three classrooms
  • Bicycle “garden” and bike parking
  • Accessible sidewalk curbs
  • Upgrade loading dock
  • New windows and window replacement at 1971 wing
  • Fire alarm replacement
  • Sprinkler repairs
  • Upgrade electrical service
  • Upgrade lighting
  • Replace water heater

Timeline

After the April 2023 meeting, the next steps are:

  • Gather feedback from community (see below)
  • Build cost estimate
  • Meet with School Design Advisory Team (SDAT)
  • Meet with user groups
  • Meet with bike garden champions
  • Reach out to art teacher to explore opportunities for student art

Please feel free to reach out to Anjali Grant, Principal Architect and Project Manager, with any questions.

Timeline for construction project between 2023 and 2025.

SDAT: February & March 2023
Schematic Design: April & May 2023
Design Development: June - October 2023
Construction Documents: October 2023-April 2024
Construction: summer 2024 - fall 2025

Feedback

The architect is currently soliciting feedback from the community on the following questions. Please contact Anjali Grant with questions or feedback.

  1. What messages of welcome to new preschool families could we include in the preschool addition?
  2. What do you want the design team to know?
  3. What do you want the design team to consider or think about?

Contacts

  • Vince Gonzales, Senior Project Manager, SPS Capital and Planning
  • Matisia Hollingsworth, Project Manager, SPS Capital and Planning
  • Deborah Northern, Manager of Equity and Engagement for Capital Projects
  • Anjali Grant, Principal, Project Manager/Project Architect, Anjali Grant Design
  • Caroline Mai, Architectural Staff, Anjali Grant Design
  • Mike McCanna, Senior Project Manager, Absher Construction
  • Garrett Tapia, Project Manager, Absher Construction

Construction Updates from SPS

John Muir Elementary School Early Learning Addition and Improvements

Latest News

The new Early Learning Addition opened in September 2025 for the 2025-26 school year.

Project Update

Major activity in August

  • Received temporary occupancy permit.
  • Completed interior build out.
  • Completed flashing and paint for the new bike shed.
  • Completed new accessible parking space and signage.

About the Project

Overview

This is a project to build a 4-classroom Early Learning addition with before- and after-school childcare support spaces.

It also includes renovating the 3rd floor of the 1971 addition from open concept to 3 classrooms, upgrades to the existing fire suppression system, and loading dock upgrades. Site work includes adding modular play equipment, bicycle parking, a bicycle garden, and work on the right-of-way curb ramp.

The existing school will remain on site during the school year while construction is going on.

Funding Source: Buildings, Technology, and Academics/Athletics V Capital Levy (BTA V), approved by voters in 2022 and a Distressed Schools Grant from the State of Washington.

Timeline

construction phase graphic showing that the school is in the Construction phase
Learn what happens during these phases
  • Predesign phase: Complete
  • Schematic design phase: Complete
  • Design development phase: Complete
  • Construction documents and permitting phase: In progress
  • Bid and award phase: Complete
  • Construction phase: In progress
  • Estimated completion: Summer 2025

Construction Progress Photos

a loader is demolishing part of a brick building
Demolition to prepare for the new preschool addition – July 2024
a bucket loader is demolishing a portion of a brick building while workers spray water
Spraying water during demolition to keep dust down – July 2024
A group of large boulders set into the ground with bark around them
Boulders relocated from front of school – Sep. 2024
a large trench outside of a building with one wall open
Subgrade footings for addition – Sep. 2024
a hallway with an open ceiling under construction
Work underway on 3rd floor classroom spaces – Sep. 2024
a person stands in a mostly complete hallway with windows on each side. the ceiling has ductwork showing and the floor is protected.
Newly painted walls and window frames in 3rd floor hallway – Sep. 2024
a wooden beam with handwriting on it
Student and teacher signatures on beam – Dec. 2024
a long narrow hole next to a brick building
Excavation for wheelchair ramp – Dec. 2024
a building under construction with beams being lifted into place
Roof beams being set – Dec. 2024
a large tent
Tenting plastic on scaffold for weather protection – Dec. 2024
a partially build wall
Exterior drywall from the interior – Dec. 2024
framed walls with a plastic tent on scaffolding above
Wall framing for the staff kitchen and preschool restrooms – Jan. 2025
two people in a space with partially framed walls with a plastic tent roof
Framing walls for 2 new classrooms and staff kitchen – Jan. 2025
two scissor lifts with people and some ceiling beams above partially framed walls inside a white tent on scaffolding
Setting glulam beams for preschool classroom – Jan. 2025
copper pipes and silver ductwork in a space under construction
New piping and ductwork – Jan. 2025
a concrete ramp in front of a brick building with temporary wood railings
New access ramp with temporary rails – March 2025
a room under construction with ductwork and framing showing
After-school care room – March 2025
wallboard with mud around door frames in a space under construction
Wallboard and door frame installation – March 2025
looking up to a partially constructed ceiling
Roof plywood installation – March 2025
A newly constructed concrete accessibility ramp with metal railings leads to the side entrance of a red-brick school, with a parking lot visible in the background.
New ADA-accessible ramp with handrails. April 2025
Two construction workers smooth fresh concrete beneath a structure decorated with colorful murals, near a fenced playground area.
Concrete work underway in bike shelter. April 2025
Entry view of a building under construction, with exposed wood framing, wiring, and construction materials scattered throughout.
Roof over framing at the PreK entry. April 2025
A room with a pitched ceiling and exposed trusses shows drywall installation in progress, with light streaming through tall windows.
Wallboard installation in PreK classroom. April 2025
A construction worker in high-visibility gear kneels on the ground beneath a concrete stairwell, preparing materials near two propane tanks. A tall ladder leans against the upper level, and safety equipment including fire extinguishers and harnesses is visible.
New bike shelter canopy – June 2025
Construction workers in safety vests and hard hats work on a site outside a brick building, assembling rebar and preparing a foundation with gravel and wood framing. A small excavator and utility vehicle are visible in the background, with fencing and construction materials scattered around the area.
Concrete footings for PreK playground – June 2025
An unfinished interior room under construction with exposed ceiling grids and visible wiring. Two open doorways lead to tiled rooms, while a stack of cable spools and safety gear sit on the floor. Wooden cubbies and cabinets are installed along one wall, and natural light enters through a skylight above.
Afterschool care space – June 2025
A large interior room under renovation with an exposed ceiling showing ducts and wiring. The walls are partially painted, and window areas are covered with plywood. Wooden cubby shelves line two walls, and a trash bin and construction materials are scattered around. A worker in a safety vest stands near a window on the right.
Northwest PreK classroom – June 2025
